Part of our Change Management series Read the overview → All 8 articles →
Blog featured image

Change Management Risk Assessment: The Leadership Dimension Most Teams Skip

The risk assessment was thorough. Budget overrun scenarios. Technology failure modes. Vendor dependency analysis. Regulatory compliance gaps. Forty-seven risks documented, categorized, and color-coded. Not one of them addressed the fact that three of the five regional directors did not believe the change was necessary.

The project team had done everything right by the risk management playbook. What they had not done: assess the people dimension. The regional directors were not on the risk register because leadership readiness is not a standard risk category. Neither is cultural resistance, change fatigue in organizations that have been through three transformations in eighteen months, or the gap between what a sponsor promises at kickoff and what a sponsor actually does when the change gets difficult.

A change management risk assessment evaluates the human factors that determine whether organizational change achieves its intended business outcomes. It examines sponsor readiness, cultural capacity, resistance patterns, and leadership capability alongside the project delivery risks that traditional assessments already cover.

Key Takeaways

  • Standard risk assessments miss the human factors that most determine change outcomes: sponsor capability, cultural readiness, and change capacity.
  • Leader readiness is the strongest predictor of change success, yet it is the dimension most assessments skip because it evaluates the people who commissioned the assessment.
  • Resistance is diagnostic data about the quality of the change design, not noise to suppress.
  • Effective assessments use interviews and behavioral observation, not just surveys, and reassess at 30- and 90-day intervals as risks shift under implementation pressure.

What Most Risk Assessments Miss

A change management risk assessment is the systematic evaluation of human, cultural, and leadership risks that could prevent organizational change from achieving its intended business outcomes. It extends traditional project risk analysis to include the people dimension that determines adoption.

Standard risk assessments are imported from project management. They identify delivery risks: timeline delays, budget overruns, scope expansion, technology failures. They build mitigation plans for each. What they routinely miss: the human risks that have the greatest potential impact on whether the change actually produces business results.

Three risk dimensions stay off most registers:

  • Sponsor capability risk. Having an executive sponsor on paper is not the same as having one who will sit in uncomfortable meetings and answer questions honestly. The risk is not absence of a sponsor. It is the gap between what sponsorship requires and what the sponsor is prepared to do.
  • Cultural readiness risk. A culture that punishes failure will resist any change that involves learning curves. The risk is not that people will resist. It is that the culture makes adoption genuinely dangerous for individuals who try and struggle.
  • Change capacity risk. The third transformation initiative in eighteen months faces a different risk profile than the first. Change capacity is not infinite, and the cumulative impact of overlapping initiatives creates fatigue that no amount of communication planning can overcome.

Three Dimensions of Change Risk

A change management risk assessment evaluates three distinct dimensions, each requiring different assessment methods and revealing different risk factors. Most organizations cover the first dimension well and skip the other two.

DimensionWhat to AssessWhat It Reveals
Organizational ReadinessResource availability, competing priorities, infrastructure readiness, historical change performanceWhether the organization can absorb this change given current demands
Leadership ReadinessSponsor commitment level, middle management buy-in, leadership consistency, change leadership skillsWhether the people leading this change have the capability it demands
Cultural ReadinessPsychological safety, change history, communication norms, conflict approachWhether the culture supports or undermines adoption

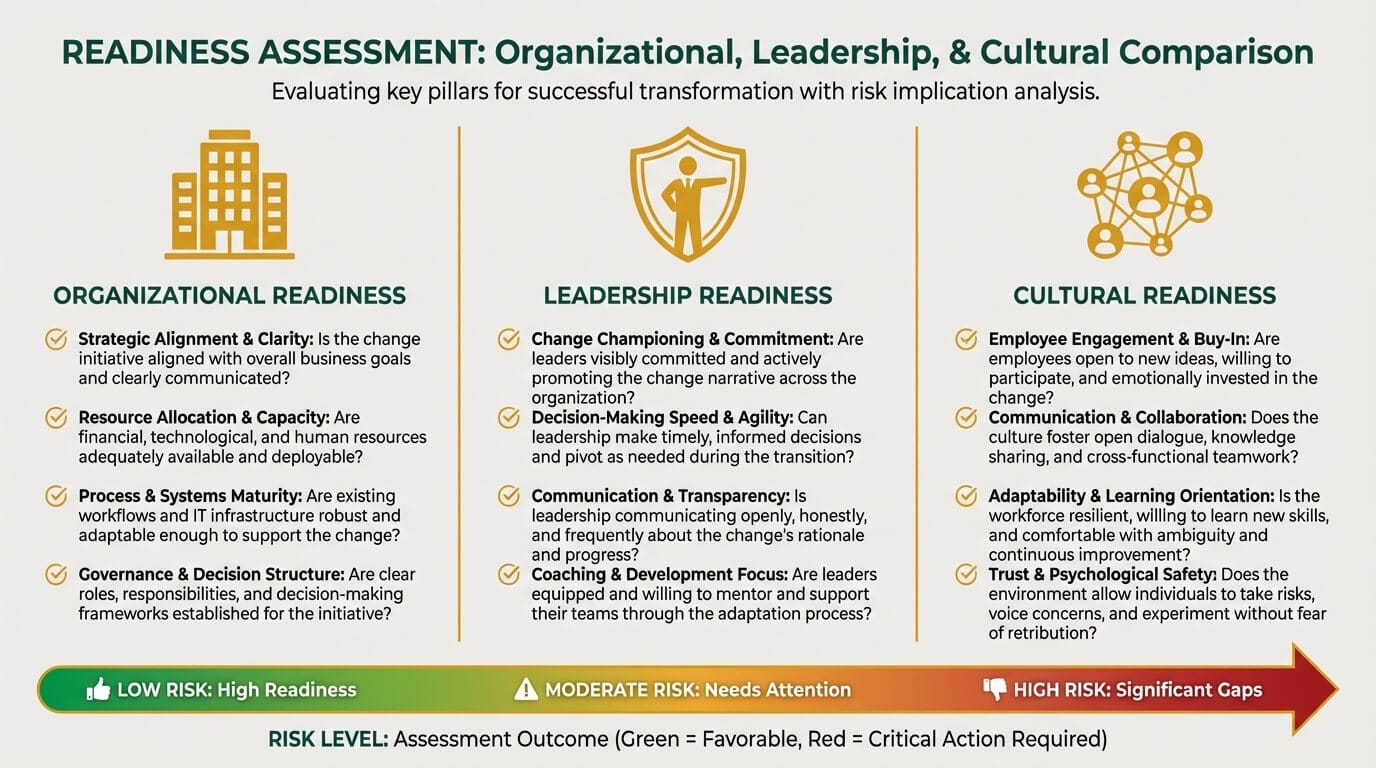

Three dimensions of change risk assessment: organizational readiness, leadership readiness, and cultural readiness with assessment indicators
Three dimensions of change risk. Most organizations assess organizational readiness well but skip leadership and cultural readiness entirely.

Organizational readiness covers the traditional territory: are resources genuinely available (not just allocated on paper), how many competing priorities are people managing, and how did the last change go? That last question matters. If the previous initiative stalled and nobody acknowledged it, people learned that leadership announces changes but does not follow through. That history shapes the likelihood of engagement with this one.

Leadership readiness is the dimension most assessments skip. It evaluates whether sponsor commitment is announced or demonstrated, whether middle management buy-in is authentic or compliant, and whether leadership behaviors match communications. A comprehensive change management approach requires assessing the people leading the change with the same rigor applied to the change itself. This means asking uncomfortable questions about whether leaders possess the change management process skills this initiative demands.

Cultural readiness determines whether any methodology will work. An organization with low psychological safety will produce compliant survey responses that mask genuine resistance. Communication norms shape whether stakeholders receive the rationale or a filtered version of it. How information actually travels versus how leaders believe it travels determines whether the assessment captures reality or reported reality. The risk analysis must account for the gap between official communication channels and the informal networks where real opinions form.

Leader Readiness: The Missing Assessment

Leader readiness assessment evaluates whether the people sponsoring and directing organizational change possess the specific capabilities this change demands—not their authority or title, but their demonstrated ability to lead through uncertainty, resistance, and sustained implementation.

After supporting organizations through change across sectors, a pattern becomes clear: the strongest predictor of change outcomes is not the quality of the change plan. It is the capability of the sponsors. And sponsor capability is the one thing most risk assessments do not evaluate.

Three capability areas separate sponsors who drive adoption from those who just hold the title:

Conversation capability. Not the town hall presentation. The one-on-one where the best engineer asks if her role still matters. The skip-level meeting where the front line asks what leadership is not telling them. These conversations happen whether sponsors are prepared or not. The risk is not that the conversations will occur. It is that the sponsor will handle them poorly, eroding trust at the moment it matters most.

Visibility commitment. Initial enthusiasm is easy to assess. Sustained visibility during months four through eight, when the change is half-implemented and fully uncomfortable, is what separates sponsors who drive outcomes from those who delegate and disappear. The capable sponsor stays present during the messy middle. The incapable one re-emerges at go-live, wondering why adoption is at 30%.

Consistency under pressure. What happens when Q3 numbers are down and the board questions the change investment? Does the sponsor hold or pivot? That moment determines more than any risk mitigation strategy. The skills for leading through resistance under pressure are capabilities to develop, not traits to assess once and assume will hold.

Assessing leadership readiness is uncomfortable because it assesses the people who commissioned the assessment. This is exactly why it gets skipped.

Reading Resistance as Diagnostic Data

Resistance in a change initiative provides diagnostic information about the quality of the change design, the effectiveness of communication, and the readiness of affected stakeholders—information that standard risk registers classify as a risk to mitigate rather than data to interpret.

An operations division was labeled “resistant to change.” The recommendation: more communication, mandatory training, executive-level pressure. What no one asked: what specifically were they resisting? When someone finally did, the answer was revealing. The proposed system eliminated a workaround they had built to compensate for a design flaw in the current system. They were not resisting change. They were resisting a change that would create a problem the organization had not identified.

When the project team heard this and redesigned the relevant module, the operations team became the strongest advocates for the new system. The resistance was not an obstacle. It was data the project needed.

Assessing resistance means evaluating four dimensions:

  • Source: Who is resisting, and what is their perspective on the business impact?
  • Nature: Is this emotional resistance (fear of the unknown) or substantive concern (they see a flaw)?
  • Pattern: Is this isolated individuals or a systemic concern across stakeholders?
  • Quality: Is the resistance about the “what” (wrong change) or the “how” (wrong approach)?

The quality of resistance also shifts over time. Early resistance that sounds like “why are we doing this?” signals that the rationale has not landed. Later resistance that sounds like “how do we handle the exception cases?” signals genuine engagement with the change. When leaders cannot distinguish between the two, they suppress engagement while mistaking compliance for readiness.

The risk is not that resistance will appear. It always does. The risk is that leaders will treat it as noise to overcome rather than risk mitigation activities informed by what the resistance reveals.

The operations team that was labeled “resistant to change” became the strongest advocates for the new system once someone asked what they were actually resisting.

Building an Assessment That Works

A change management risk assessment produces actionable findings when it follows four principles: interview-based data collection, multi-level scope, behavioral observation, and scheduled reassessment at defined intervals.

Interview-based, not just survey-based. Surveys capture what people are willing to write down. Interviews capture what they are willing to say. Neither captures what they actually do, which is why observation must complement both. Relying on surveys alone produces a risk assessment that reflects reported attitudes, not actual readiness.

Multi-level scope. Sponsors, middle managers, and front-line employees each carry a different risk profile. The sponsor may be committed while middle management quietly undermines through passive compliance. A force field analysis applied to each organizational level reveals where driving forces and restraining forces actually operate.

Observation-informed. The gap between what stakeholders report and what they do is where the highest-impact risks hide. Planning meetings where the same concerns surface repeatedly, decisions that get revisited without new information, and teams that agree in meetings but do not change their processes afterward. These behavioral signals tell you more about readiness than any questionnaire.

Time-bound reassessment. Risk profiles shift. Assess at launch, at 30 days, and at 90 days. Each assessment reveals risks that were not visible earlier because they only emerge under the pressure of actual implementation. Change management metrics tracked alongside the assessment provide quantitative evidence of how risk factors are evolving.

Warning

The most common assessment pitfall: conducting the assessment and then softening findings that implicate leadership. If the assessment reveals that the sponsor’s communication style is a risk factor and the report rephrases it as “stakeholder engagement could be strengthened,” the assessment has failed its purpose.

From Assessment to Action

A risk assessment without action is documentation for the post-mortem. Each risk identified should map to a specific response: a conversation to have, a capability to develop, a support structure to build, or a timeline to adjust. The assessment’s value is proportional to the organization’s willingness to act on what it reveals.

When the assessment identifies leadership capability gaps, the response is development, not documentation. A sponsor who avoids difficult conversations, middle managers who lack the skills to facilitate adoption, an executive team that has not aligned on why this change matters: these are not problems to document. They are capabilities to build. Executive coaching addresses these capability gaps at the speed organizational change demands, developing the specific leadership behaviors the assessment flagged as risks.

The organizations that use assessments well share one practice: they map every identified risk to a named owner and a specific action with a deadline. Sponsor capability gap becomes a coaching engagement. Cultural resistance becomes a communication strategy redesign. Change capacity overload becomes a sequencing decision. The assessment drives the plan. Without that mapping, the assessment is a document that describes the problem without creating the conditions to solve it.

The question underneath every change management risk assessment is not “what might go wrong?” It is “do the people leading this change have the capability to handle what will go wrong?” Because something will. The organizations that weather change well are not the ones that identified every risk. They are the ones whose leaders had developed the capability to respond when risks materialized. That is not an assessment problem. It is a development problem, and it is the difference between a risk register that documents and one that actually protects.

Your Risk Assessment Found Leadership Gaps. Now What?

Most assessments identify the problem without creating conditions to solve it. A conversation with our team can map those findings to specific development actions.

Book a Free Consultation →
